About the Exam

Former ISTQB Advanced Level certification for professionals who manage software testing. It covers test planning, monitoring and control, risk-based testing, test metrics, estimation, defect management, team skills, and test process improvement. Passing demonstrated advanced competence in test management for roles such as testers, test managers, test consultants, project managers, and product owners.

Exam Topics

  • Managing the Test Activities50%
  • Managing the Product26%
  • Managing the Team24%

How to Use This Practice Exam

  1. Browse — Read each question, select your answer, and reveal the explanation.
  2. Exam Mode — Simulate real exam conditions with a timed session and score report.
  3. Learn Mode — Spaced repetition schedules questions you struggle with for long-term retention.

Download the Full Exam PDF

Get every question and answer in a clean, printable PDF built for offline study. Purchase once, keep permanent access, and re-download the latest version anytime.

Last updated December 4, 2025 at 5:34 AM

Topic filter
Retired questions
Question sort
Questions per page

QuestionQ1

Managing the Test Activities

You are the Test Manager for a project developing a Pay-TV company web customer portal that enables customers—with a smartcard and a set-top box—to buy digital content.

On the select page, the system shows a dialog in which the customer can choose the digital-content items he or she is interested in. From this page, he or she can add one or more items to a shopping cart. An item comprises a product and a duration.

There are three product types: Movie, sport, and premium (movie and sport).

There are four possible durations: 1 months, 2 months, winter (from the beginning of January to the end of March), and summer (from the beginning of July to the end of September).

Every combination of product and duration is permitted to define an item. Therefore, there are twelve possible items. A maximum of six distinct items may be added to the shopping cart at one time.

When the customer chooses to check out, he or she goes to the purchase page, where the total cost of the shopping cart can be paid in three different ways:

  • using a credit voucher
  • using credit already charged on the smartcard
  • using a credit card (accepted credit cards are Visa, MasterCard, and Great Wall Card)

The customer may log out from both the select and purchase pages. In that case, no purchase is made.

You decide to use a blended risk-based and reactive testing strategy, and the following are a subset of the exit criteria for system testing:

  • EXCR1- Each "critical" quality risk item must be covered by at least one test condition
  • EXCR2- Each "critical" requirement must be covered by at least one test condition

You are using a risk-based testing strategy. Test execution time is very limited. Assume all product risk items require approximately the same test effort.

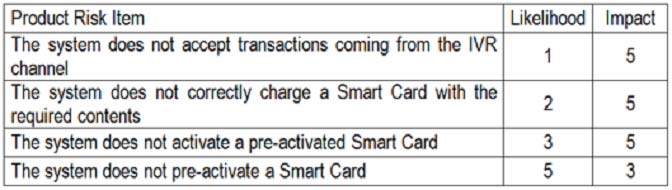

Question Image

Which of the following answers describes the best execution schedule in this scenario?

Explanation

Risk-based test execution prioritizes product risks by their exposure, calculated from likelihood and impact. The pre-activation and activation risks both have the highest exposure (15); pre-activation is scheduled first because it has the higher likelihood. Incorrect smart-card charging follows with exposure 10, and IVR transaction acceptance is last with exposure 5.

Community Discussion

No comments yet. Be the first to start the discussion!

QuestionQ2

Managing the Product

Assume you are working on a CAS (Conditional Access System) for Pay-TV that enables authorized users to access, select, and transfer services and media. Authorized users may select services through different channels: Web Customer Portal, IVR (Interactive Voice Response), Call Centre, and SMS. The system uses a Smart Card to receive and decrypt the broadcast encrypted control words that permit decryption of pay-per-view TV. Each authorized user must have a Smart Card and a Set-Top Box to view the content.

The following is an extract from the product risk analysis document:

Both likelihood and impact are rated using this scale: (1 Very low, 2 Low, 3 Medium, 4 High, 5 Very High).

The required test environment and code have been delivered. All test cases for every identified product-risk item have been written and are ready for execution.

The database used to store the Smart Cards is empty; therefore, only new Smart Cards can be used during test execution.

A Smart Card can be activated only if it was previously pre-activated. Thus, the post-conditions for executing the test cases that test pre-activation of the Smart Card are the pre-conditions for Smart Card activation.

Which of the following statements is the most effective stakeholder contribution to completing the failure mode analysis table?

Question Image

Explanation

In failure mode and effects analysis (FMEA), priority should incorporate business and operational impact, making the aircraft pilot and customer representative appropriate contributors. Assessing detection requires knowledge of the system design, implementation, and test techniques, so the chief software engineer, system architect, and expert tester should contribute. FMEA assigns severity, priority, and detection ratings to identified quality risks.

Learn more

Community Discussion

No comments yet. Be the first to start the discussion!

QuestionQ3

Managing the Test Activities

The key objectives the senior management team seeks to achieve are:

  • to reduce costs associated with dynamic testing
  • to use reviews to ensure that the project remains on course for success and follows the plan
  • to use reviews as a well-documented and effective bug-removal activity that follows a formal process with clearly defined roles
  • to determine the effectiveness of reviews in terms of phase containment
  • to improve phase-containment effectiveness

Which of the following answers would be expected to describe the best way to achieve these objectives?

Explanation

Formal exit-phase reviews support a documented review process with defined roles and detect defects earlier, reducing reliance on more costly dynamic testing. Phase containment can be assessed and improved only when defect information records the phase in which defects were introduced, detected, and removed; comparing those phases identifies defects that escaped their originating phase and directs process improvements.

Learn more

Community Discussion

No comments yet. Be the first to start the discussion!

QuestionQ4

Managing the Test Activities

You are estimating the effort required for integration-testing activities in a new project. Consider the following factors, which may affect that estimate:

  1. Availability of reusable test systems and documentation from earlier, similar projects
  2. Unanticipated timing of component arrivals
  3. Stability of the integration test team (no turnover)
  4. Many geographically distributed sub-teams

Which of the following statements is true?

Explanation

Unexpected component arrivals introduce uncertainty into integration-test scheduling and dependencies. Numerous geographically distributed sub-teams increase coordination and communication complexity. Both factors can adversely affect the accuracy of a test-effort estimate, whereas reusable assets and a stable test team generally support more reliable estimation.

Learn more

Community Discussion

No comments yet. Be the first to start the discussion!

QuestionQ5

Managing the Test Activities

Which statement about test reporting activities is correct for a project that adopts an iterative lifecycle model with very short iterations, such as two-week iterations?

Explanation

Test reporting remains important in short iterative lifecycles because it communicates test progress, results, defects, and quality risks. The resulting information supports post-iteration review sessions and decisions before the next iteration begins.

Community Discussion

No comments yet. Be the first to start the discussion!
